Construction of an electrical substation

Nature of the work :
Work is continuing in the Pointe-Saint-Charles sector. In parallel with the work on the elevated structure, several buildings required for the power supply of the REM have to be constructed. These will be located along Wellington Street, in the railway embankment between St. Patrick and Bridge streets. Work will begin in mid-February and continue until the summer.
Here are the main steps :
Phases |
Schedule |
Mobilization of site |
Starting February 17, 2021, |
Construction of the foundations of the substation buildings |
Week of February 22, 2021 |
Construction of building retaining walls |
Starting in June 2021, |
Impacts and mitigation measures :
- This work may generate noise, dust and vibrations. Environmental specialists will conduct monitoring activities to ensure that the project complies with applicable noise and air quality criteria.
- A portion of Wellington Street will be obstructed between St. Patrick Street and Bridge Street. Flaggers and appropriate signage will be used to redirect traffic.
- Access to businesses and companies in the area will be maintained at all times.

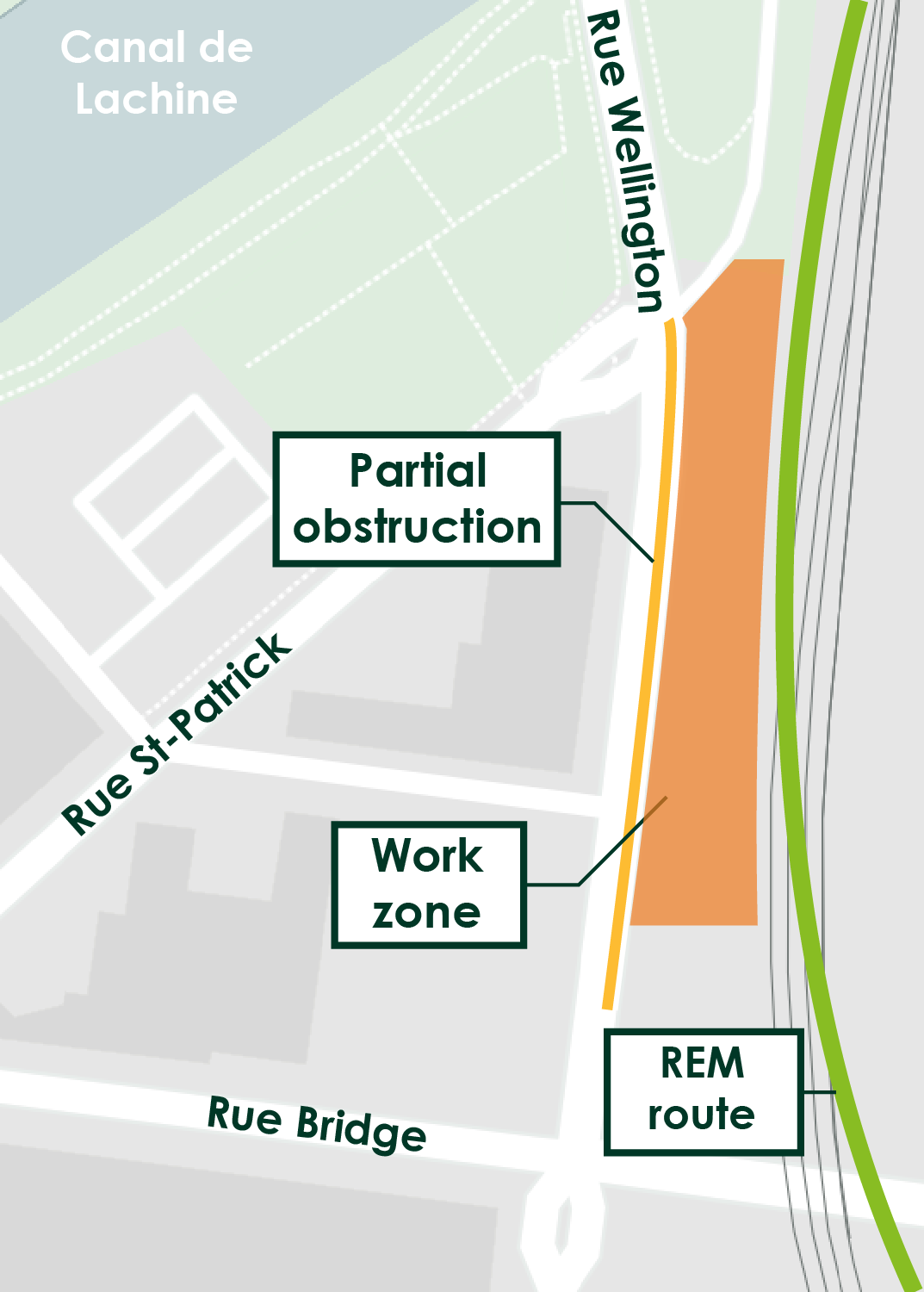

The work site area is shown below:

*Dates sujettes à changement.
For all questions | 1 833 REM-INFO
Write us via the contact form of the "Contact us" page. You may contact us by phone on weekdays between 8:00 am and 5:00 pm.
