Progress of the REM project, Les Iles Laval

Construction activities
Fall 2020 From 7 a.m. to 7 p.m.* on weekdays and weekends
North Shore

Nature of work

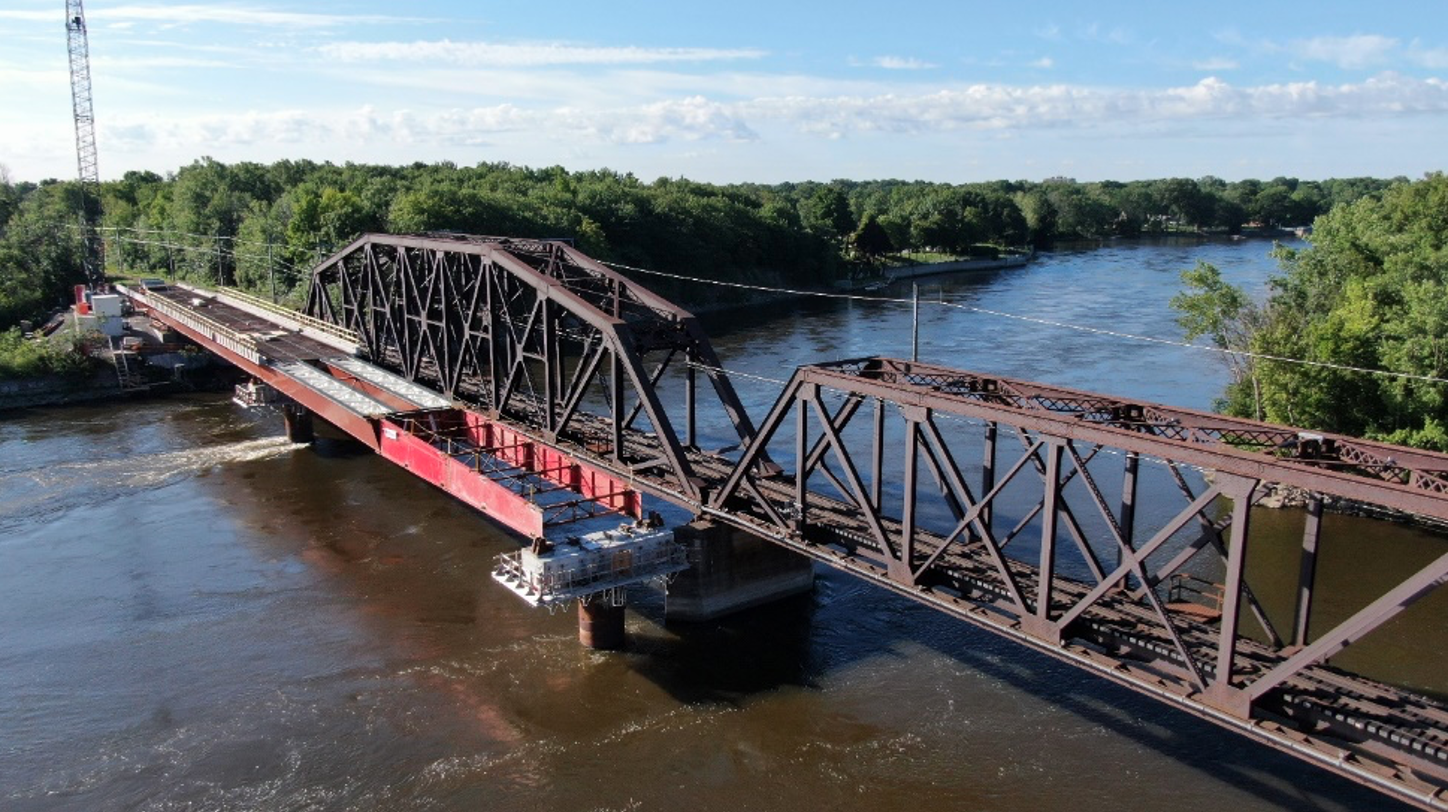

Rivière-des-Prairies Railway Bridge 1

Construction of the new railway bridge adjacent to the existing railway bridge continues this fall. Beams were slid into place using the launching gantry; next, they will be seated on the bearing devices and permanently installed.

Construction of the abutment on the south riverbank and the retaining walls, in preparation for doubling the track will also take place in fall of 2020.

Les Îles Laval

In the Îles Laval, public utility companies such as Hydro-Québec, as well as telecommunications companies such as Bell and Vidéotron will be actively relocating their respective networks to make way for the future REM facilities.

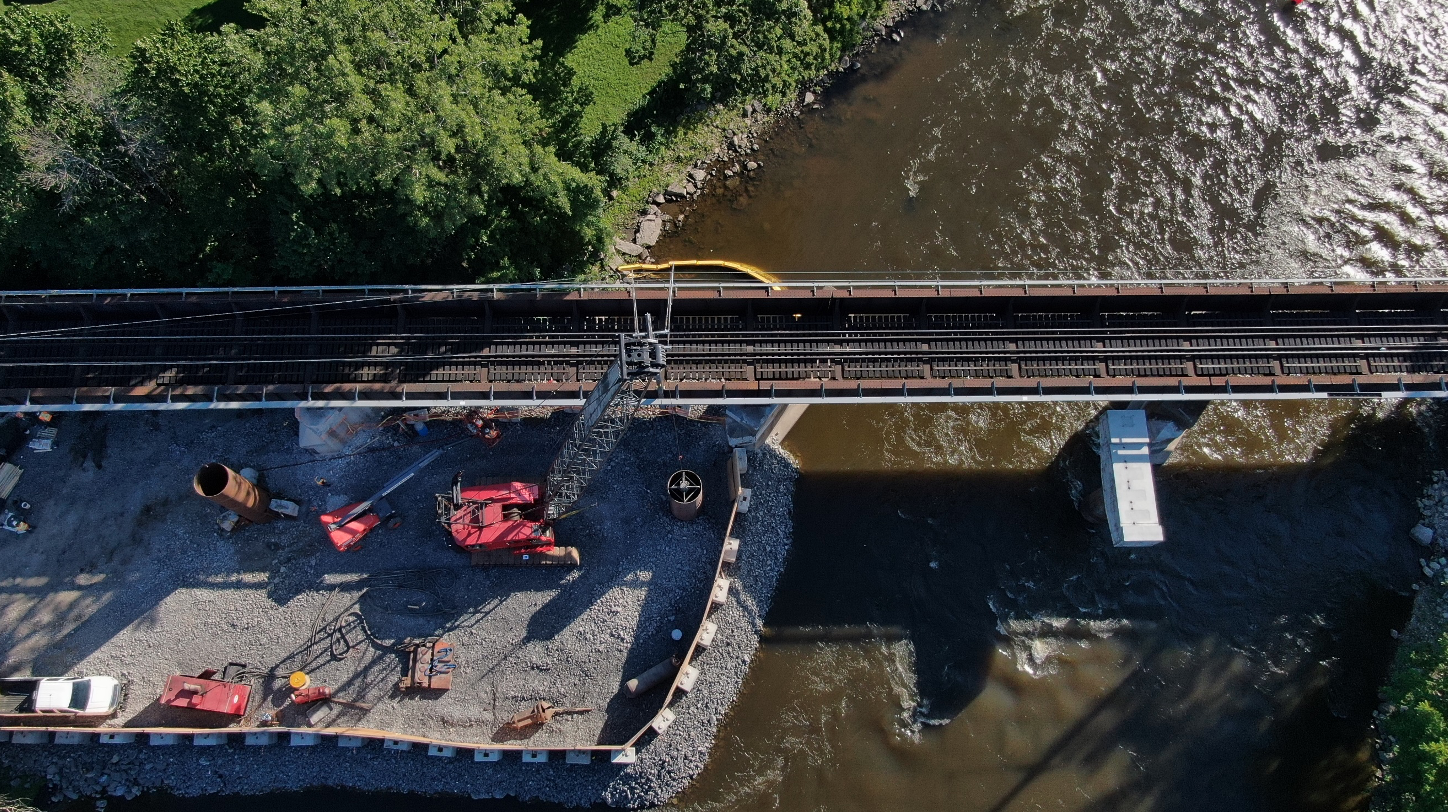

Rivière-des-Prairies Bridge 2

On the north side of Rivière-Des-Prairies, construction of the pillars and pierheads continues so the beams can then be installed, and concrete curbs poured to complete the northern portion of the railway bridge.

The work schedule is as follows**

Schedule

  Work

 Impacts

Fall 2020



Rivière-des-Prairies Railway Bridge 1 (RDP1)

  • Abutment work (south shore)
  • Concrete work on the bridge deck (south shore)



This work may have the following impacts:

  • Noise
  • Vibration
  • Truck route

Fall 2020



Les Îles Laval

  • Relocation of public utilities: Overhead power line along the railway and telecommunications lines (carried out by third parties)



This work may have the following impacts:

  • Noise
  • Vibration
  • Truck route
  • A pedestrian path was built along Mistral Road to ensure pedestrian safety.

Fall 2020



Rivière-des-Prairies Bridge 2 (RDP 2)

  • Construction of foundations (pillars and pierheads on north shore)
  • Installation of beams for the prefabricated slab (north shore)
  • Concrete curbing of the railway structure
  • Removal of the jetty



This work may have the following impacts:

  • Noise
  • Vibration
  • Truck route
  • Du Tour Road beneath the railway will be closed; only local traffic will be permitted.
  • Estimate of 50 trucks per day during peak hours for construction of the jetty (three weeks).



*Work will take place from 7 a.m. to 7 p.m. Work before and after this time period will be necessary to mobilize and demobilize all elements required to carry out the work and to clean up the site. Noisy work will be concentrated in the daytime and evenings. Due to the nature of the activities being performed, work cannot be interrupted while it is in progress. It must be completed in order to maintain the integrity of the existing infrastructure. Should this situation arise, the work period will be extended to complete the work already begun
**The current sequence and dates are subject to change without notice.

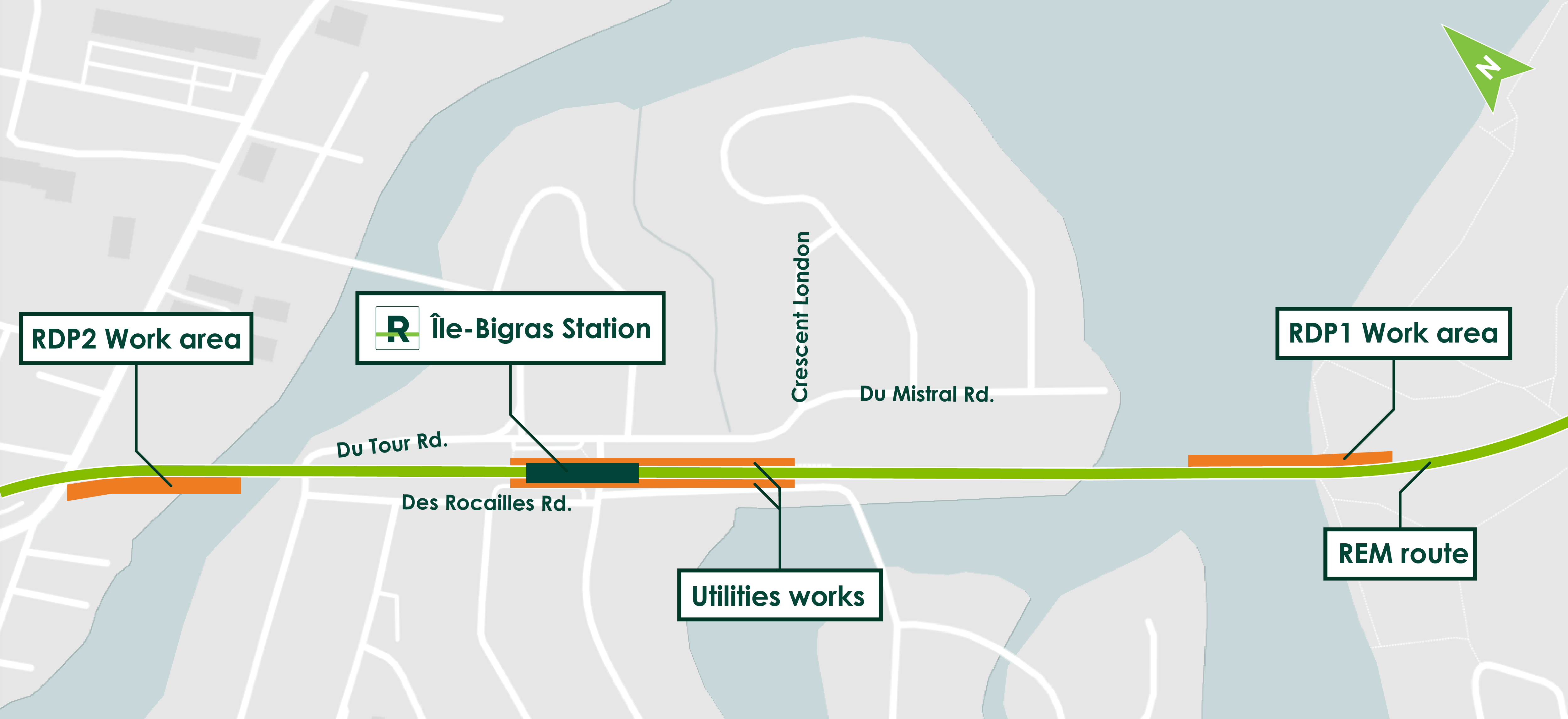

The following map shows the various work zones

For all questions | 1 833 REM-INFO
